9.0 Subsequent Measurement of Goodwill
Executive Summary
| Project Type | Research |
|---|---|
| Project Scope | Limited scope |
Purpose of the paper
This paper requests the Board's approval of an updated Project Initiation Plan (PIP) for the research project on the subsequent measurement of goodwill.
Summary of the Issue
In October 2021, the Board approved a PIP for a limited scope research project to analyse the potential impact of transitioning to an amortisation model for the subsequent measurement of goodwill. The research proposed in the October 2021 PIP was completed as planned between October and December 2021. That research found that a potential transition to an amortisation model for the subsequent measurement of goodwill:
- Would be unlikely to have a significant impact on financial stability or significant operational or cost implications for UK IFRS preparers, according to our survey results.
- Could lead to material financial statement changes for UK IFRS reporters, given the size and growth trend of goodwill balances, although this is not of itself a compelling reason to defer any change.
At the December Board meeting, further field testing was highlighted as a possible next step to underpin the initial research findings in relation to transitional arrangements. The updated PIP proposes the Secretariat's approach to the further research work to field-test transitional arrangements.
Decisions for the Board
The Board is asked to approve the updated PIP. Changes from the October 2021 PIP are highlighted in grey.
Recommendation
That the Board approves the updated PIP.
Appendices
Appendix 1 Updated PIP: Subsequent Measurement of Goodwill Research Project
Project initiation plan: Subsequent measurement of goodwill
| Project Type | Research |
|---|---|
| Project Scope | Limited scope |
Overview
- The IASB has begun redeliberating the preliminary views in its DP 2020/1 Business Combinations: Disclosures, Goodwill and Impairment (the Discussion Paper). In the Discussion Paper, the IASB supported retaining the impairment-only model for the subsequent measurement of goodwill. Responses to this preliminary view were mixed: some respondents supported maintaining the impairment-only model whereas others recommended the reintroduction of amortisation.¹ The UKEB Secretariat's response advocated a hybrid model for the subsequent measurement of goodwill. In the hybrid model, an annual amortisation charge is supported by impairment testing.
- The proposed project responds to and expands on a request from IASB staff. The IASB discussed its plan for redeliberations on this project at its September 2021 meeting. It agreed that further work would be prioritised to support redeliberations on goodwill measurement. To inform the Board's redeliberations on this topic, IASB staff identified two specific areas of analysis that they intended to carry out with support from national standard setters. These areas were:
- How the useful life of goodwill is determined for amortisation purposes under national GAAP; and
- The potential impacts of transitioning to an amortisation model.
- How a hybrid model can provide information that is useful for users.
- Cost implications of a hybrid model.
- We intend to publicly promote the field-testing and will seek input from users, preparers, auditors, and academics.
- The proposed field-testing of transitional arrangements will explore:
- The relative merits of prospective and retrospective application;
- The advantages and disadvantages of full retrospective application;
- The factors that management would consider in determining the useful life of goodwill for amortisation purposes if retrospective application were required and how those factors might vary for different acquisitions and components of goodwill;
- Whether any additional disclosures relevant to those factors might also be useful information for users of accounts and if so, what those additional disclosures would be;
- Whether assumptions applied in determining the useful life of goodwill for amortisation purposes would be consistent with assumptions about the allocation of goodwill to cash-generating units for impairment testing purposes, and;
- The cost and resource implications of a potential transition.
- As part of the proposed field-testing, we will also seek UK stakeholder views and evidence on:
- The IASB's proposed disclosures on business combinations.³
- The frequency of trade and assets acquisitions with material goodwill and the implications of these goodwill balances for distributable profits.
- The proposed project contributes to the influencing activities delegated to the UKEB in SI/2019/685(5)(b).⁴
- Undertaking the project is relevant for the UKEB and its stakeholders because:
- Much of the current debate on the subsequent measurement of goodwill assumes that an amortisation model would result in a loss of useful information by imposing an arbitrary period for the amortisation of goodwill. Field-testing retrospective application of transitional arrangements will provide an opportunity to explore whether a hybrid model, which combines amortisation with regular impairment tests, could provide a more faithful representation and continue to provide information that is relevant to users.
- Goodwill represented approximately 15% of total assets for UK FTSE 350 and AIM entities in 2020; and
- M&A activity by IFRS reporters in the UK is expected to increase in the immediate and medium term.⁵
- We anticipate that undertaking the project will deliver the following benefits for the UKEB:
- Timely engagement with the IASB: the project provides an opportunity to support the IASB in a timely manner.
- Profile building: the project provides an opportunity to contribute new, UK-specific evidence to the ongoing international debate on goodwill.
- Stakeholder engagement: the outreach on this project will contribute to building relationships with UK preparers, users, auditors, and regulators.
Project objectives, scope, and output
- The IASB's objective in undertaking this project is to assemble relevant evidence to underpin their redeliberations on subsequent measurement of goodwill.
- The UKEB's objectives in undertaking this project are to:
- Build the UKEB's reputation as a significant and positive participant in the development of global accounting standards; and
- Demonstrate the UKEB guiding principle of thought-leadership by anticipating IASB's information needs and contributing UK-specific evidence to the international debate on goodwill; and
- Demonstrate the UKEB guiding principle of accountability through outreach to UK stakeholders.
- The intended outputs of the project are:
- A comprehensive analysis in response to the IASB's request; and
- A research paper presenting project findings and conclusions, to be published on the UKEB website.
- Once the research scoped in this PIP is complete, the UKEB may wish to consider further research or developing the research paper in formats suitable for wider publication. We intend to consult with the Board on any additional research or development of the research paper for wider publication before commencing any work outside the scope of this PIP.
- The UKEB will propose presenting the research paper at future international meetings with other global standard setters, including the July 2022 Accounting Standards Advisory Forum (ASAF) meeting and September 2022 International Forum of Accounting Standard Setters (IFASS) meeting.
Approach
- The project approach will comprise desk-based research and stakeholder outreach. The goodwill research project team will be alert to opportunities to co-ordinate with the UKEB's intangibles project team, to ensure efficiency and consistency between the two research projects where appropriate.
- The table in appendix A outlines the proposed questions, initial findings and proposed further work. Secretariat will provide updates to the Board as necessary throughout the project.
Key milestones and proposed timeline
- The proposed high-level project timeline is as follows:
| Month | Activity / Milestone |
|---|---|
| October 2021 | Board meeting: approval of initial PIP |
| October – November 2021 | Desk-based research |
| November 2021 | Outreach activities |
| December 2021 | Board meeting: approve analysis for submission to IASB |
| December 2021 | Share analysis with IASB and publish on UKEB website |
| January 2022 | Board meeting: approval of updated PIP |
| February 2022 | Develop field-testing materials |
| March – April 2022 | Field-testing with stakeholders |
| May 2022 | Board meeting: approve research paper for publication on UKEB website |

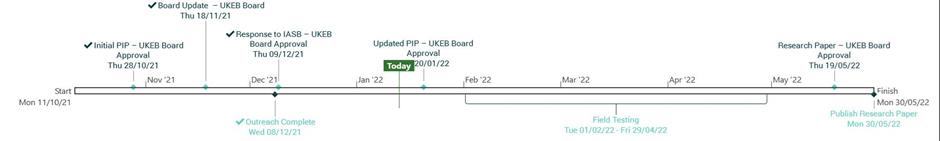

The timeline is shown below:

Assumptions
- We have made the following assumptions in developing this project initiation plan:
- Planned further research will result in sufficient depth and breadth of analysis (planned further research is shown in appendix A).
- There are no significant changes to project scope.
- The resource allocated to the project is 50% of a project director's time and 40% of a project manager's time for the duration of the project. These resources are available and included in the current UKEB budget.
- IASB timelines do not change.
- We will not prepare a feedback statement or a statement of compliance with due process for the project, since neither are required by the current draft of the UKEB Due Process Handbook and would not be the best use of staff resource.
Next Steps
- Subject to Board approval, we will commence the research and analysis activities outlined in Appendix 1.
- Subject to Board approval, we will present the research paper to the UKEB May 2022 Board meeting.
Appendix A: Summary of areas for analysis, initial findings and proposed further research
| Question | Initial Findings | Further Research Proposed |
|---|---|---|
| Section a: Analyses requested by IASB | ||
| 1 If IASB decides to reintroduce goodwill amortisation and the transition requires adjusting historical goodwill balances, what are the potential effects of writing-off significant amounts of historic goodwill on transition and amortising the remaining historic goodwill balances on: | ||
| a Financial position | Goodwill exceeded net assets for approximately 11% of FTSE 350 entities in 2019. The proportion of FTSE 350 entities whose goodwill exceeds net assets has remained broadly constant at approximately 11% between 2005 and 2019. | Update analysis for 2020 year-ends. Extend sample to other listed entities outside FTSE 350. Analyse trends by sector and size of entity. Field-testing to: Develop numerical examples illustrating potential impacts of transitioning to an amortisation model. Analyse age profile of goodwill for a sample of UK IFRS reporters to ascertain the value of goodwill that would need to be written off on transition. Research different treatments of goodwill on transition. |
| b Debt covenants | There is no standard approach to the treatment of goodwill in debt covenants. Some include goodwill as an asset when assessing credit and when setting covenant terms whilst others do not. | Survey to lenders and preparers to establish: Whether covenant terms typically include or exclude goodwill. How a change in subsequent measurement of goodwill could impact existing covenants. Field-testing to provide further insights on the above. |
| c Distributable profits, dividend payments, and capital maintenance | Under the Companies Act 2006 and UK common law, distributions are made by individual companies and not by groups. The group accounts are therefore not relevant for the purpose of determining a company's profits available for distribution, dividend payments or capital maintenance. Amortisation or impairment of goodwill arising on consolidation has no direct impact on distributable profits, dividend payments or capital maintenance. |
Field-testing to provide further insight on the frequency of trade and assets business combinations and the materiality of goodwill arising from them. |
| d Listing requirements | An initial review of the UK Listing Rules has not identified any specific requirements regarding financial position. | Further review of relevant sources to identify whether transitioning to an amortisation model would lead to breaches of listing rules and other related requirements. |
| e Tax | There is tax relief for some kinds of goodwill under current UK legislation. | Numerical example to illustrate any impact on current and deferred tax of transitioning to an amortisation model. |
| f Other legal and regulatory requirements | - | Further review of relevant sources to identify whether transitioning to an amortisation model would lead to breaches of other regulatory requirements. |
| 2 In national GAAP: | ||
| a Is a default period provided? What are the reasons for setting a default period and how was that default period determined? | UK GAAP requires amortisation of goodwill on a systematic basis over its useful life. Management should make a reliable estimate of the useful life of goodwill. If, in exceptional cases, an entity is unable to make a reliable assessment of the useful life of goodwill, the life shall not exceed 10 years. Earlier UK GAAP contained a rebuttable presumption that the maximum useful economic life of goodwill was 20 years. |
Explore why 10 years was set as the cap where management are unable to make a reliable assessment of the useful life of goodwill. |
| b Can entities deviate from a default period based on specific facts and circumstances (rebuttable presumption) and, if so, whether in practice entities tend to rebut that presumption and deviate from the default period, and what evidence is provided to support any deviation? | Our initial sample of large private UK companies has found entities which either: Voluntarily report under IFRS Or Do not have goodwill |
Extend sample of large private UK companies to identify UK GAAP reporters with goodwill. Outreach to UK GAAP preparers, auditors, and regulator to analyse: How a reliable estimate of the useful life of goodwill is made Whether it is assessed separately for each acquisition |
| c Is useful life established on the basis of management's best estimate and, if so, whether a list of indicators/factors to be considered is provided (for example: cash flow streams, synergies, payback period), how entities are making these estimates and whether auditors and regulators can, and do, challenge these assumptions? | Cost and resource implications of the assessment Frequency with which the estimate of the useful life of goodwill is revised and reasons why Experience of auditing estimates of useful life of goodwill |
|
| Section B: UKEB staff proposed questions | ||
| 1 How can a hybrid model provide useful information for users? | Investor contributions to the international debate suggest that amortisation does not provide useful information, and in fact reduces the decision-usefulness of the financial statements. However, these views are often based on the assumptions that: 1. An amortisation-only model would be introduced. 2. The useful life of goodwill for amortisation purposes would be determined by reference to a default or cap. 3. Disclosures relating to the impairment test would be lost. |
Further analysis of user responses to IASB's DP and to FASB's goodwill measurement consultation. Field testing and outreach to explore whether and, if so, how: 1. A hybrid model could meet information needs of users including investors and creditors. 2. Requiring management to determine the useful life of goodwill for amortisation purposes would provide relevant information. 3. The IASB DP's proposed disclosures on business combinations could provide relevant information. |
| 2 Cost implications of a hybrid model. | International debate has identified concerns that introducing a hybrid model would create an additional cost burden for entities, given it would require amortisation in addition to impairment testing. | Outreach to preparers, auditors, and users to assess cost implications of preparing and auditing amortisation supported by indicator-only impairment testing compared to costs of an impairment-only model. |
Footnotes
-
UK EB staff analysis estimates that a marginal majority of respondents advocated the reintroduction of amortisation. ↩
-
IASB's project timeline was updated on 17 December 2022. It reflects IASB's current project plan to decide on the project's direction in H2 2022. Previously IASB's intention was to vote on the proposals in the DP in Q2 2022. ↩
-
The DP proposes disclosure of anticipated synergies, strategic rationale for the business combination, and the metrics used to monitor the business combination. IASB staff have developed illustrative examples of these disclosures which we intend to incorporate in our proposed field-testing. ↩
-
The International Accounting Standards and European Public Limited-Liability Company (Amendment etc.) (EU Exit) Regulations 2019: https://www.legislation.gov.uk/uksi/2019/685/made ↩
-
Source - Lexis Nexis market tracker trend report: Trends in UK Public M&A in 2020. ↩
